Project Management Glossary: Key Terms

Definition of Cost performance index

What is the cost performance index (CPI)?

Cost performance index (CPI) is a critical project management metric that measures the financial efficiency of project work by comparing the value of work completed to the actual costs incurred. It's calculated as a ratio revealing whether a project is delivering value at, above, or below the budgeted cost per unit of work.

CPI is part of earned value management (EVM), a widely adopted methodology for integrating scope, schedule, and cost measurements. Unlike simple budget tracking that only compares planned vs. actual spending, CPI accounts for work actually completed, providing a more accurate picture of financial performance. This distinction is crucial: a project can be under budget simply by falling behind schedule, but CPI reveals whether the money being spent is producing proportional value.

What does the cost performance index measure?

Cost performance index measures resource utilization efficiency throughout project execution, revealing how successfully financial investment converts into completed deliverables.

What CPI reveals

  • Financial efficiency of work completion
    CPI compares earned value (budgeted cost of completed work) against actual costs. If a project completes $100,000 of planned work but spends $120,000, CPI reveals the 17% efficiency loss that raw budget tracking obscures.
  • Project health beyond the timeline
    A project ahead of schedule with a CPI of 0.75 is burning budget at an alarming rate, potentially running out of funds before completion despite timeline success.
  • Trend prediction for final costs
    CPI provides early warnings when projects trend toward significant overruns, triggering corrective action or stakeholder communication before problems compound.
  • Team and vendor productivity
    A team with a CPI of 1.15 consistently delivers more value per dollar than one at 0.85, informing future resource allocation and vendor selection.
  • Process effectiveness
    If all projects using a particular methodology consistently show CPI below 0.9, the process itself may be inefficient, requiring methodology refinement rather than demanding better team performance.

What CPI doesn't measure

CPI is not a standalone success indicator. A project with excellent CPI can still fail if it:

  • Delivers the wrong product
  • Misses critical deadlines
  • Ignores quality standards

Interpret CPI alongside schedule performance, quality metrics, and stakeholder satisfaction for a complete project health assessment.

How to calculate the cost performance index?

To calculate CPI, you only need two inputs for your chosen status date:​

1. Earned value
The budgeted cost of the work that has actually been completed so far.
Often computed as:

Earned value (EV) = Percentage of work completed × Total budget

2. Actual cost
The real cost incurred to complete that work to date, including labor, materials, vendors, and overheads.​

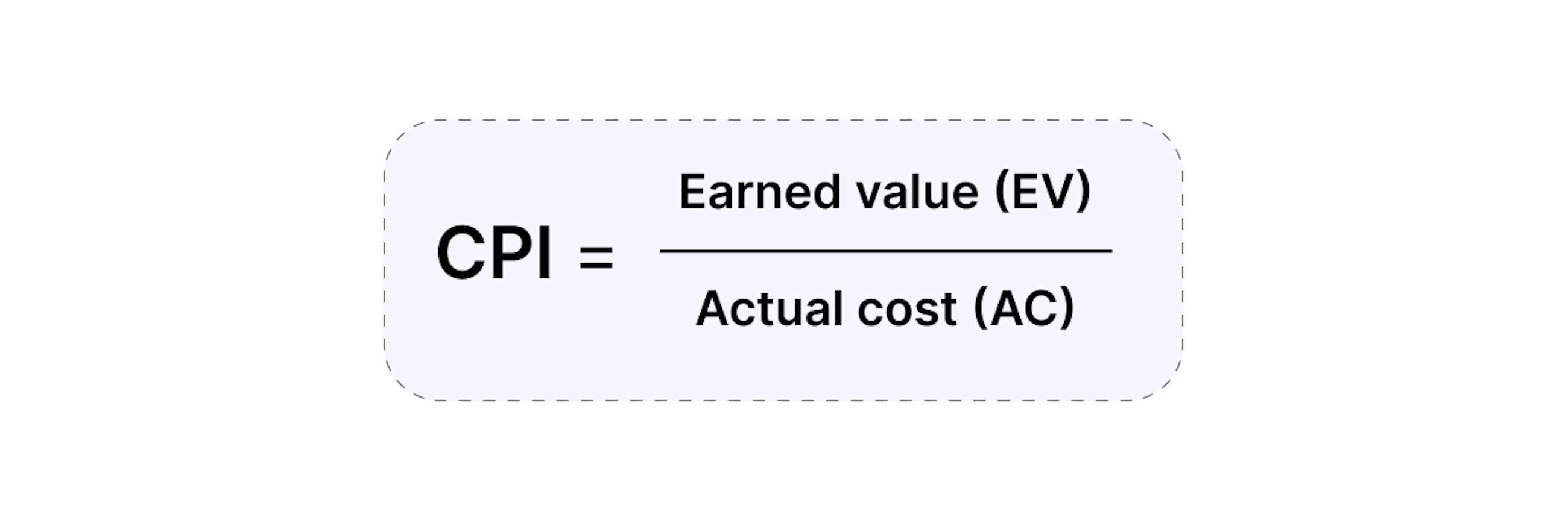

3. Apply the CPI formula

Example of calculating:

Budget for a feature: 100,000
Work completed so far: 50% → EV = 0.5 × 100,000 = 50,000
Actual cost so far: 70,000
CPI = 50,000 / 70,000 ≈ 0.71
The project is significantly over budget (only 0.71 value per 1.0 cost)

Understanding how to calculate CPI is only half the equation: interpreting what those numbers mean for your project determines whether you can take corrective action in time.​

What is a good cost performance index value?

A "good" CPI value is any value equal to or greater than 1.0, with practical nuance depending on context:​

CPI slightly above 1.0 (e.g., 1.05–1.15)

  • Indicates healthy cost efficiency: the project is delivering more value than it costs.
  • Common in well‑estimated projects or where teams find smarter ways to deliver.​

CPI close to 1.0 (0.95–1.05)

  • Usually acceptable; small deviations are normal and may even out over time.
  • Many organizations treat this band as “on budget” in practice.​

CPI significantly below 1.0 (e.g., < 0.9)

  • Indicates meaningful overspend relative to value delivered.
  • Should trigger an investigation into causes (scope creep, underestimation, productivity issues, unexpected complexity).​

For long‑running or high‑risk projects, a good cost performance index is typically anything at or above 1.0, sustained over time with limited volatility. The key is not just hitting 1.0 once, but keeping CPI stable while still delivering the planned scope and quality.​

How does Enji help track and improve CPI?

Enji provides comprehensive CPI monitoring and optimization through automated tracking, predictive analytics, and actionable intelligence that transforms cost performance management from retrospective accounting into proactive financial control.

  1. Real-time earned value calculation
    Enji's Project Margins feature automatically calculates Earned Value by integrating planned work from Jira stories and epics with budget allocations, then tracking actual completion status. Unlike manual EVM, which requires spreadsheet updates, Enji continuously monitors work completion and instantly recalculates EV as tasks progress, providing current CPI visibility without manual data entry.
  2. Financial transparency for stakeholder communication
    Enji generates stakeholder-ready cost performance reports through PM Agent, translating technical CPI data into business language. Instead of presenting raw metrics requiring interpretation, executives receive clear summaries: "Project delivering $0.89 of value per dollar spent, primarily due to underestimated API integration complexity. Projected budget overrun: $73,000. Recommend extending the timeline or descoping two lower-priority features to restore budget alignment."
  3. Automated actual cost tracking
    Enji tracks Actual Cost by aggregating data from multiple sources: timesheets (Global Worklogs), contractor invoices, and resource allocation costs. The platform automatically converts hours worked into monetary costs based on defined labor rates, calculates contractor expenditures, and factors in overhead, producing comprehensive AC figures that feed directly into CPI calculations.
  4. Live CPI dashboards and trend analysis
    Enji's dashboards display current CPI alongside historical trends, showing whether cost performance is improving, stable, or declining over weeks and months. Color-coded indicators (green for CPI > 1.0, yellow for 0.90-1.0, and red for < 0.90) provide instant visual assessment of financial health. Trend charts reveal whether the current CPI represents a temporary fluctuation or a sustained pattern requiring intervention.
  5. Predictive cost-at-completion forecasting
    Using the current CPI, Enji projects final project costs through estimate at completion (EAC) calculations. If a $500,000 project shows a CPI of 0.85 at 40% completion, Enji forecasts final costs of approximately $588,000, alerting managers to a likely $88,000 overrun with sufficient lead time to implement corrective actions or renegotiate scope with stakeholders.
  6. Variance analysis and root cause identification
    When CPI deviates from acceptable ranges, Enji's Project Narrative™ technology automatically analyzes contributing factors by correlating cost performance with other project signals. The system identifies whether CPI decline stems from resource inefficiency (lower-than-expected productivity), scope expansion (unplanned work consuming budget), or technical complexity (tasks requiring more effort than estimated), providing actionable insights rather than just flagging problems.
  7. Proactive monitoring and pattern detection
    Employee Pulse monitors team workload and productivity patterns that impact cost performance, identifying when team members are overloaded or underutilized. Combined with Routine Alerts that flag unusual work patterns or capacity issues, managers receive early signals when factors affecting CPI efficiency are emerging, enabling intervention before cost overruns materialize.

Enji's CPI tracking reports financial performance while enabling proactive management that prevents budget crises, improves estimation accuracy, and builds stakeholder trust through transparent, data-driven communication.

Key Takeaways

  • Cost performance index (CPI) measures project financial efficiency by comparing earned value (budgeted cost of completed work) to actual costs incurred, revealing whether projects deliver expected value per dollar spent.
  • CPI provides visibility into resource utilization efficiency, enables accurate cost-at-completion forecasting, identifies productivity patterns across teams, and reveals process effectiveness, though it must be interpreted alongside schedule, quality, and satisfaction metrics for a complete project assessment.
  • Calculate CPI using the formula Earned value ÷ Actual cost, where values between 0.95 and 1.05 generally indicate healthy performance, above 1.05 suggest efficiency gains, and below 0.85 signal serious budget problems requiring immediate intervention.
  • Good CPI varies by industry, project phase, and organizational context; R&D projects often target 0.90-1.00 due to innovation uncertainty, while construction aims for 0.95-1.05, with the most meaningful benchmarks coming from your organization's historical performance patterns.
  • Enji automates CPI tracking through real-time earned value calculation, integrated actual cost monitoring, live dashboards with trend analysis, predictive cost-at-completion forecasting, root cause variance analysis, and proactive alerts, transforming cost performance from retrospective reporting into proactive financial control.
  • Enji's Project Margins and Project Narrative™ enable transparent stakeholder communication by translating technical CPI metrics into business language, while portfolio-level analysis reveals high-performing patterns worth replicating and improves estimation accuracy across future projects.
